The Capital Project web page is your one-stop destination for the latest updates on ongoing capital projects. Whether you are a Stakeholder, Faculty, Staff, Teacher, Parent, Student, or Community Member, this page provides the most up-to-date information on project timelines, budgets, and progress. You’ll find detailed project plans, schedules, and documents, as well as regular updates from project teams and stakeholders. Stay informed and engaged with the latest developments by visiting the Capital Project web page today. (links below will open in new tabs)
SEQR Draft Scope for Environmental Impact Statement -Architect’s Report
July 2023 Capital Project Newsletter
June 2023 Capital Project Newsletter
To view the full PowerPoint, please click here: BOE Update – 01-12-2023
Click here if you want to view the Capital Project Archives.

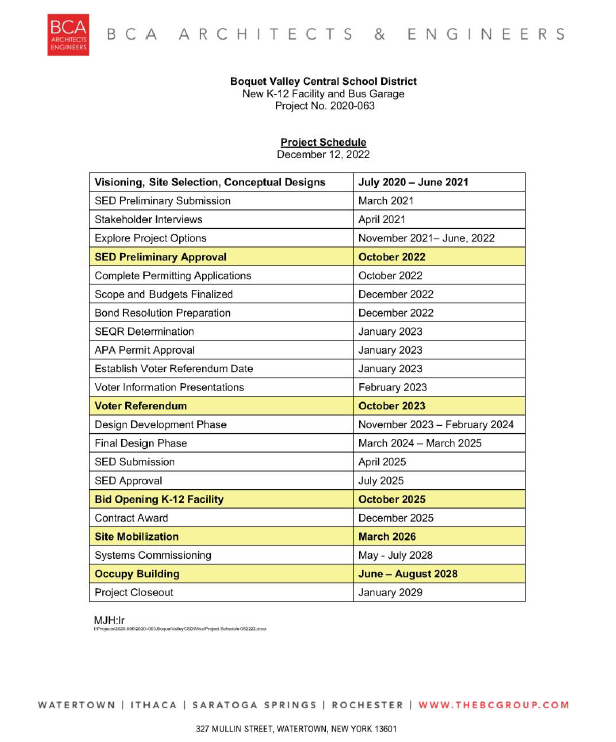

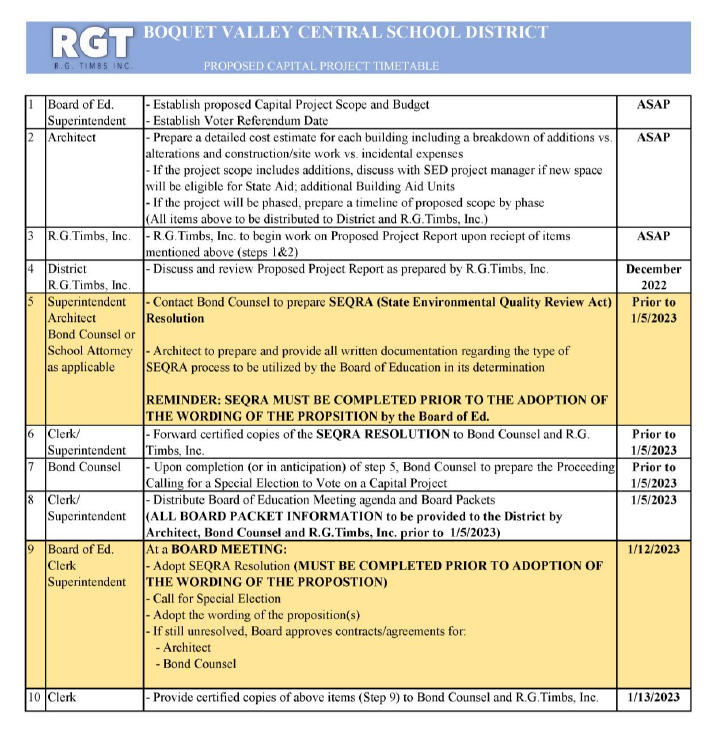

Where We Stand Today
- SED Preliminary Review Approval and MCA
- Finance Schedules and Taxpayer Impact
- Plans Scaled Back to Reduce Costs
- Agreement with County for Thrall Dam Property Conveyance
- EIS and APA Permitting Applications
- Options for an Alternative Plan

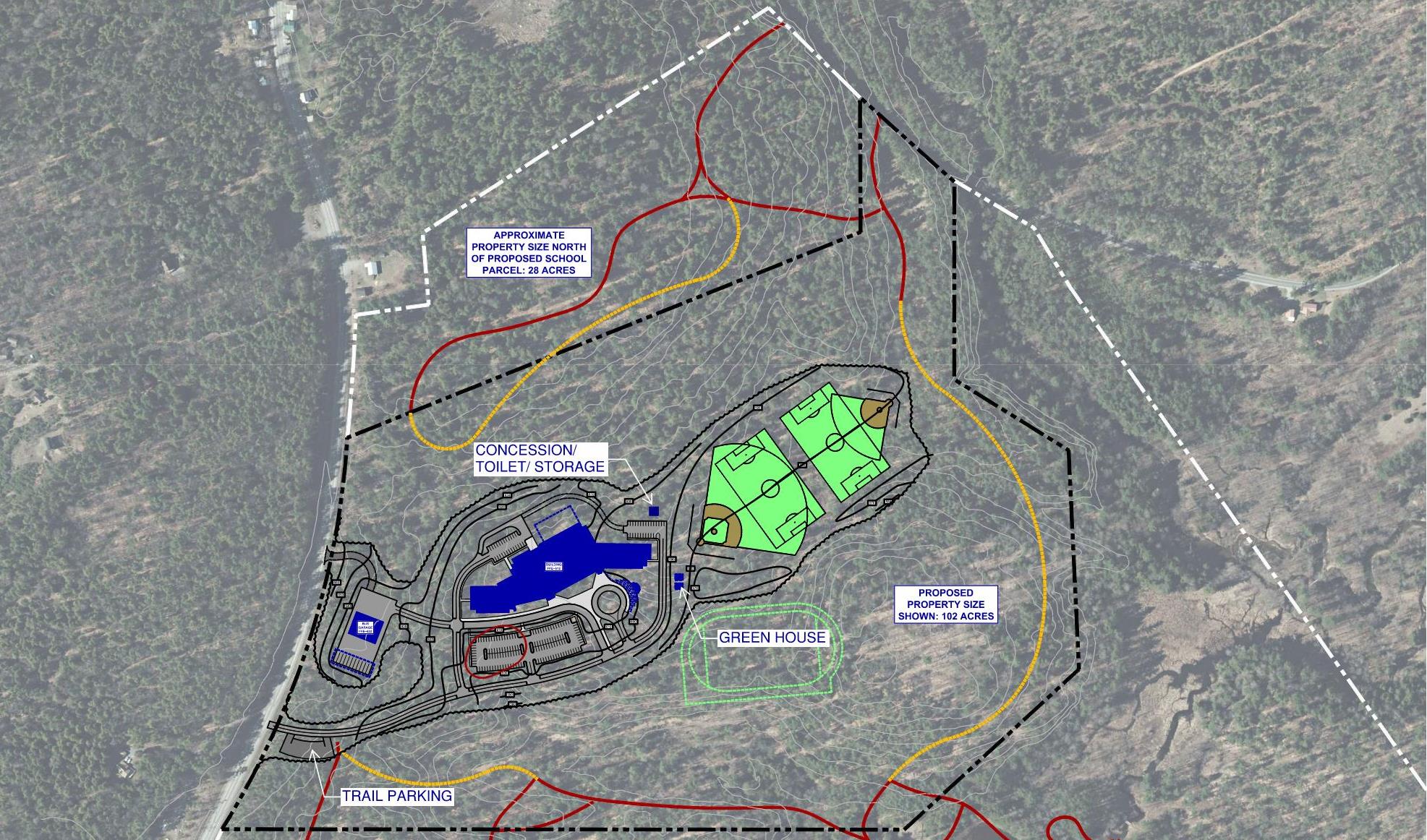

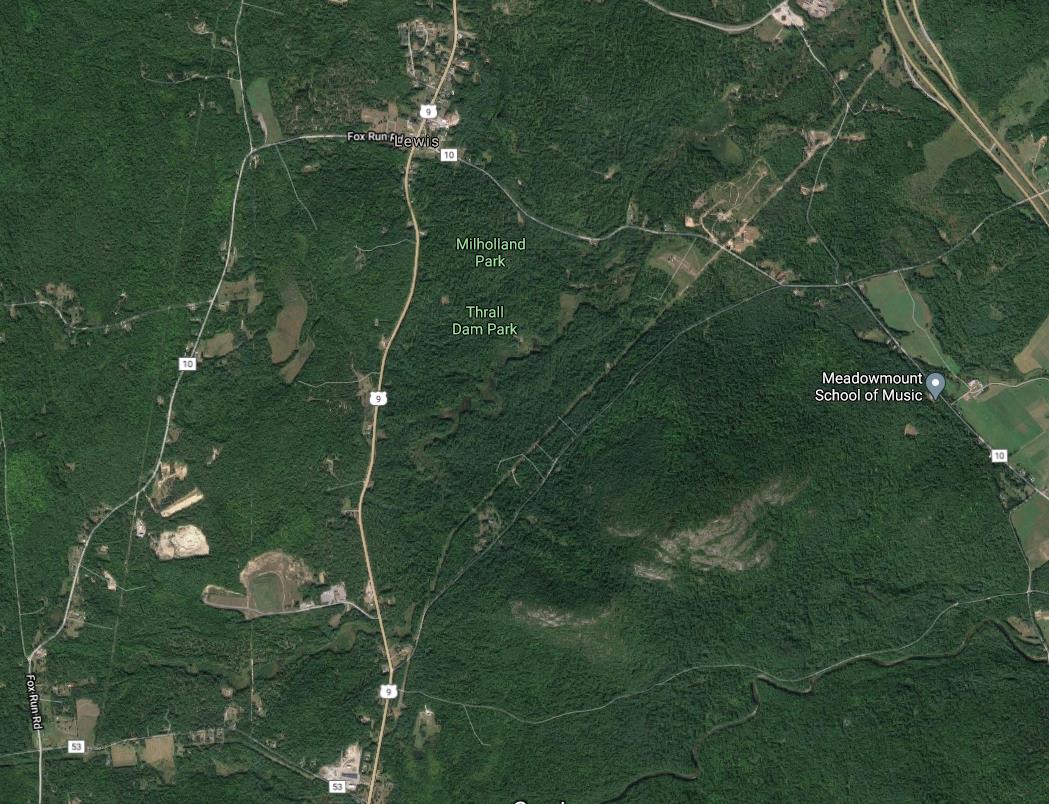

Thrall Dam Park

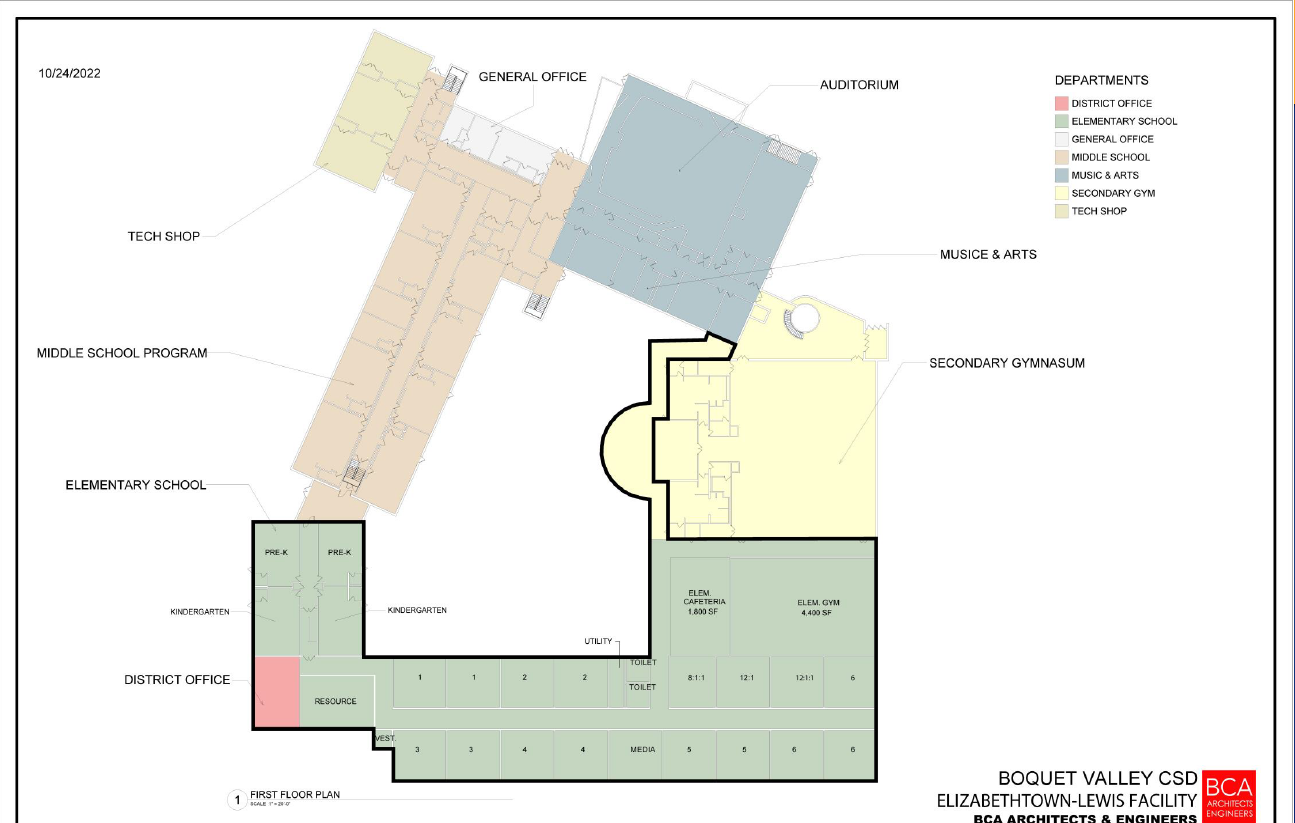

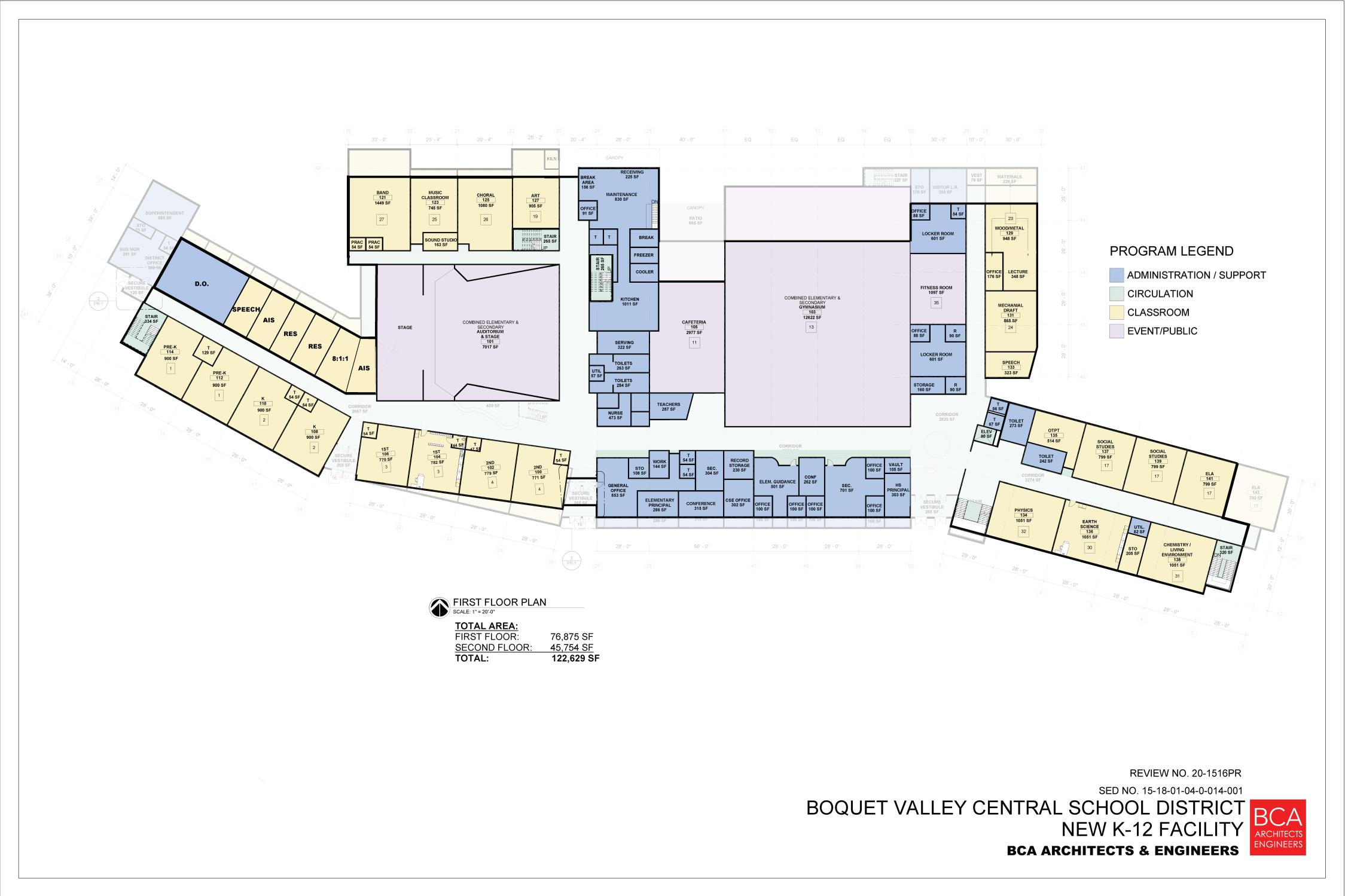

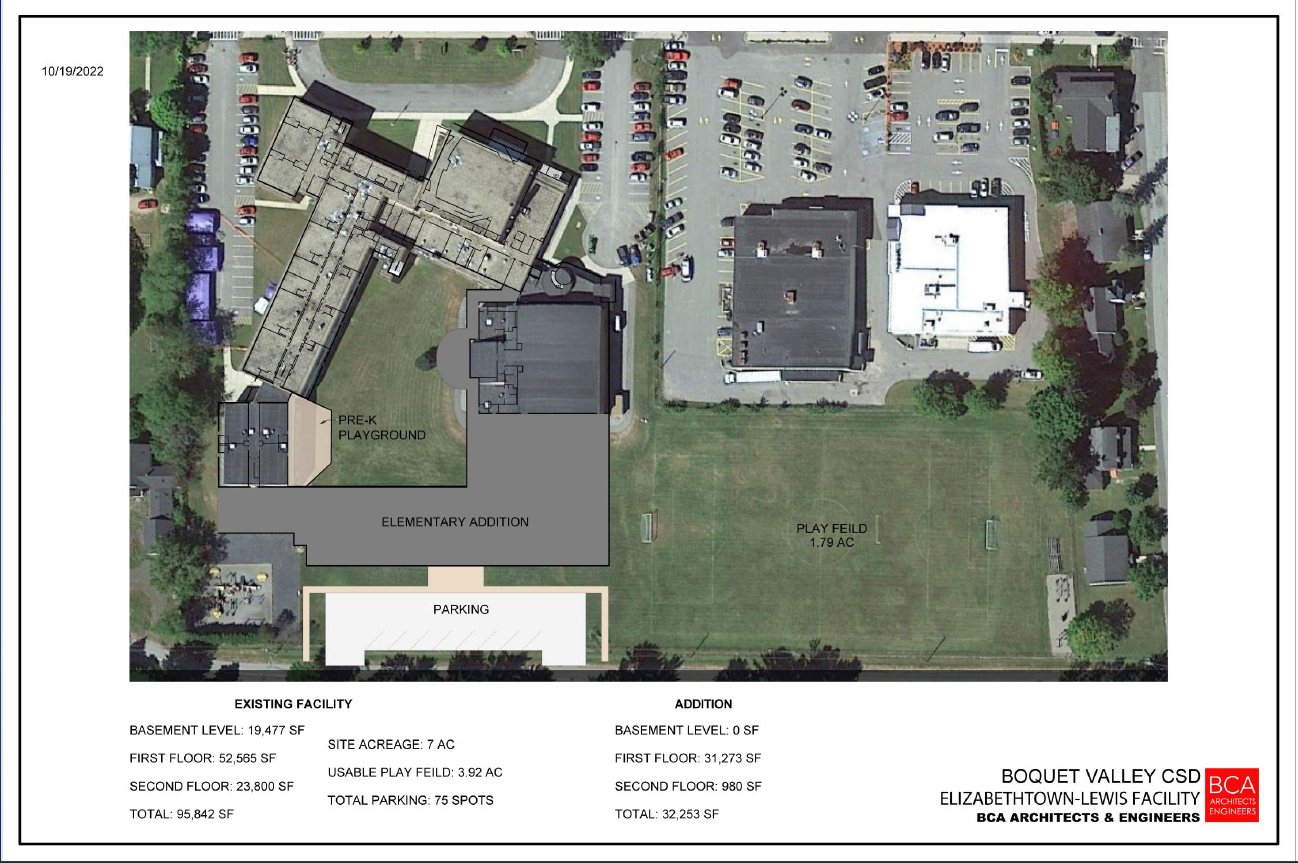

The Floor Plan for the 1st Floor

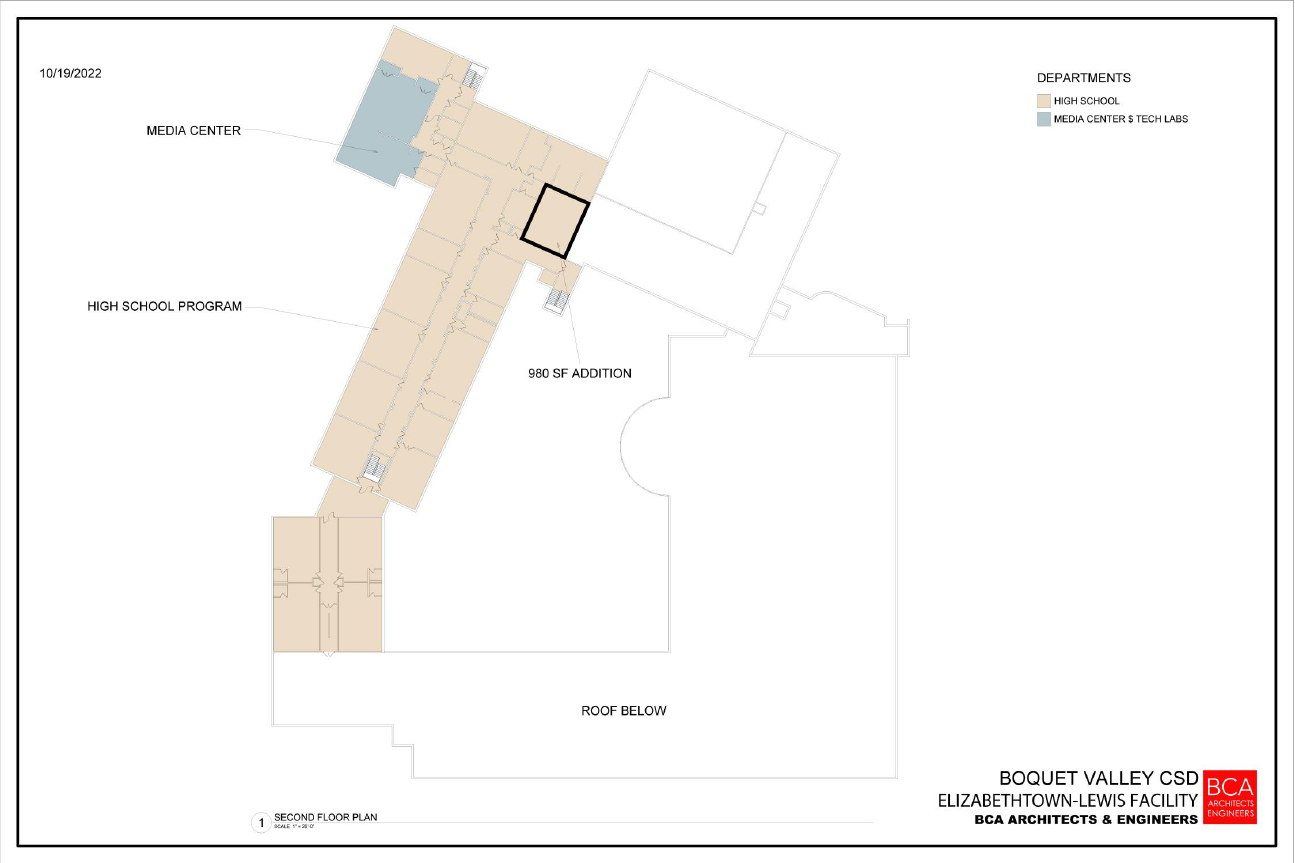

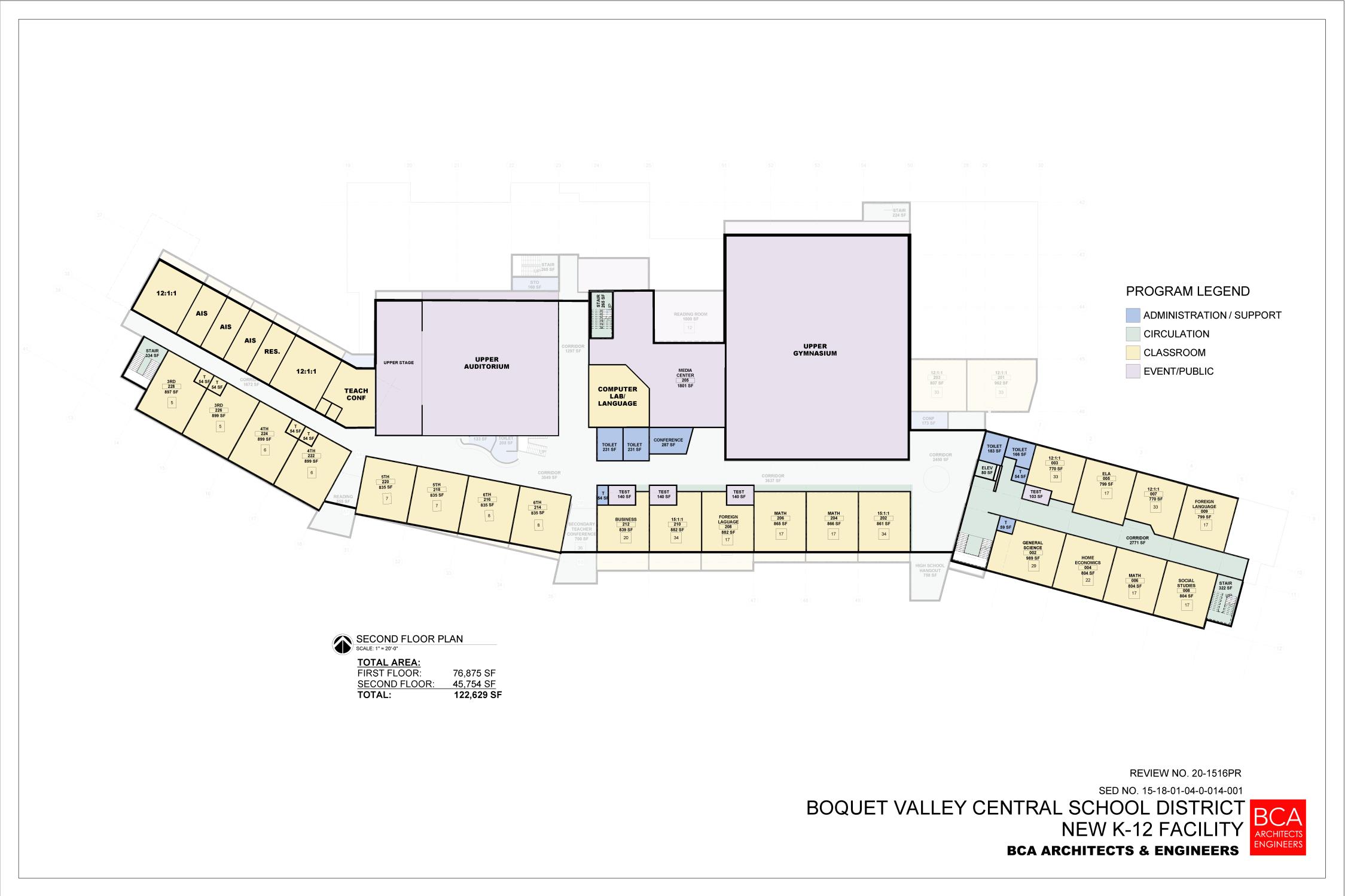

The Floor Plan for the 2nd Floor

Lake View Campus Expansion

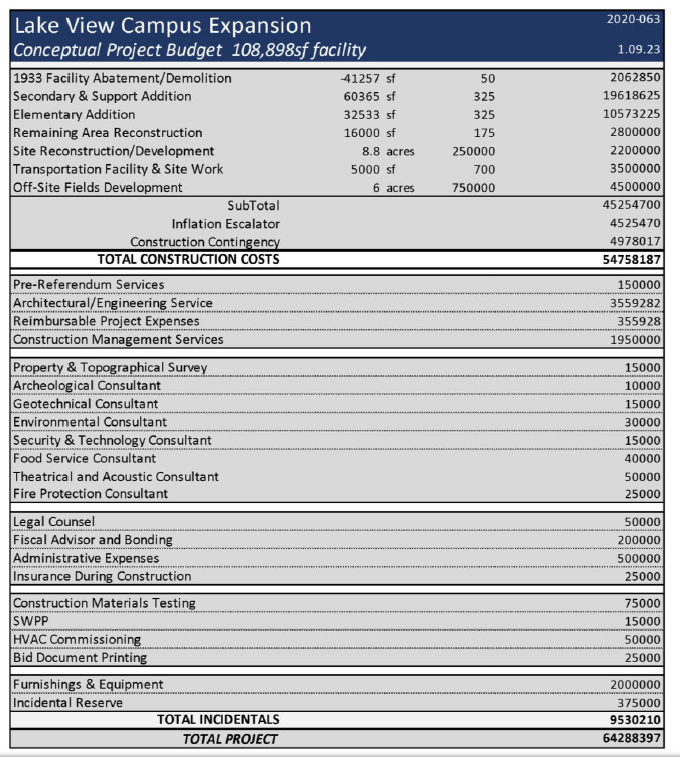

Conceptual Project Budget 108,898 square feet facility

Mountain View Campus Expansion

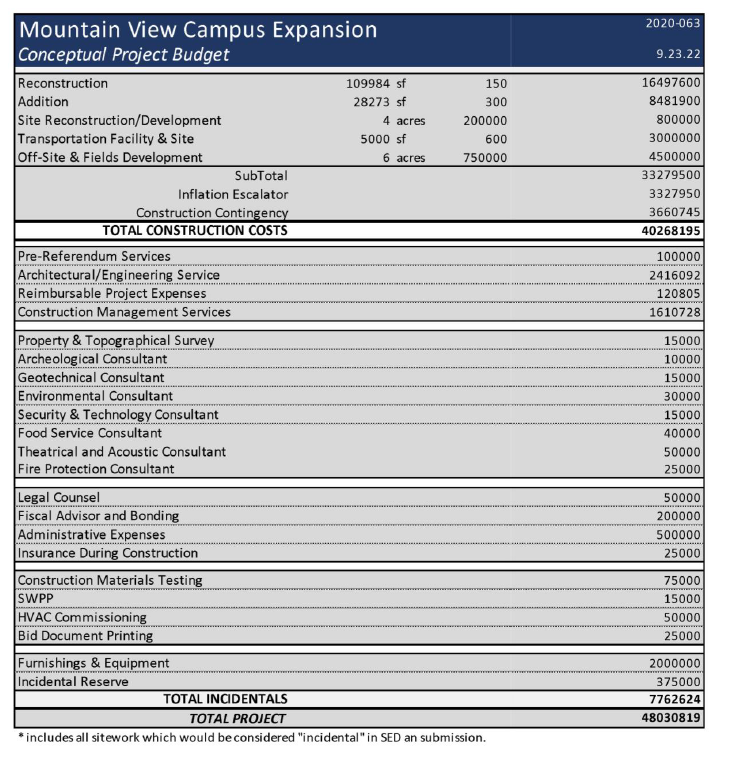

Conceptual Project Budget

$53,414,000

What’s Next
- Determine the Communities Sentiment
- Finalize Schematic Plans
- Obtain Environmental and APA Permits
- Prepare Bond Resolution
- Finalize Debt Schedules
- Establish the Vote Date
- Prepare Public Information Presentations
